en

Angola projects - The Lobito Corridor

The Lobito Corridor

AngolaExpert · Project File

The Lobito Corridor

In Brief

  • The railway runs roughly 1,300 kilometres from the port of Lobito to Luau on the Congolese border, continuing some 450 kilometres to Kolwezi in the DRC.
  • A thirty-year concession was awarded in November 2022 to Lobito Atlantic Railway, held by Trafigura and Mota-Engil with 49.5 per cent each and Vecturis with 1 per cent.
  • Financing of USD 753 million reached financial close in July 2026: USD 553 million from the US Development Finance Corporation and USD 200 million from the Development Bank of Southern Africa.
  • The operator moved more than 200,000 tonnes in 2025 against a rehabilitated design capacity of 4.6 million tonnes a year.
  • Global Witness estimated in December 2025 that up to 6,500 people around Kolwezi could face displacement from the rehabilitation.

The Route

A colonial railway, rebuilt by China, now carrying Western strategy

Geography

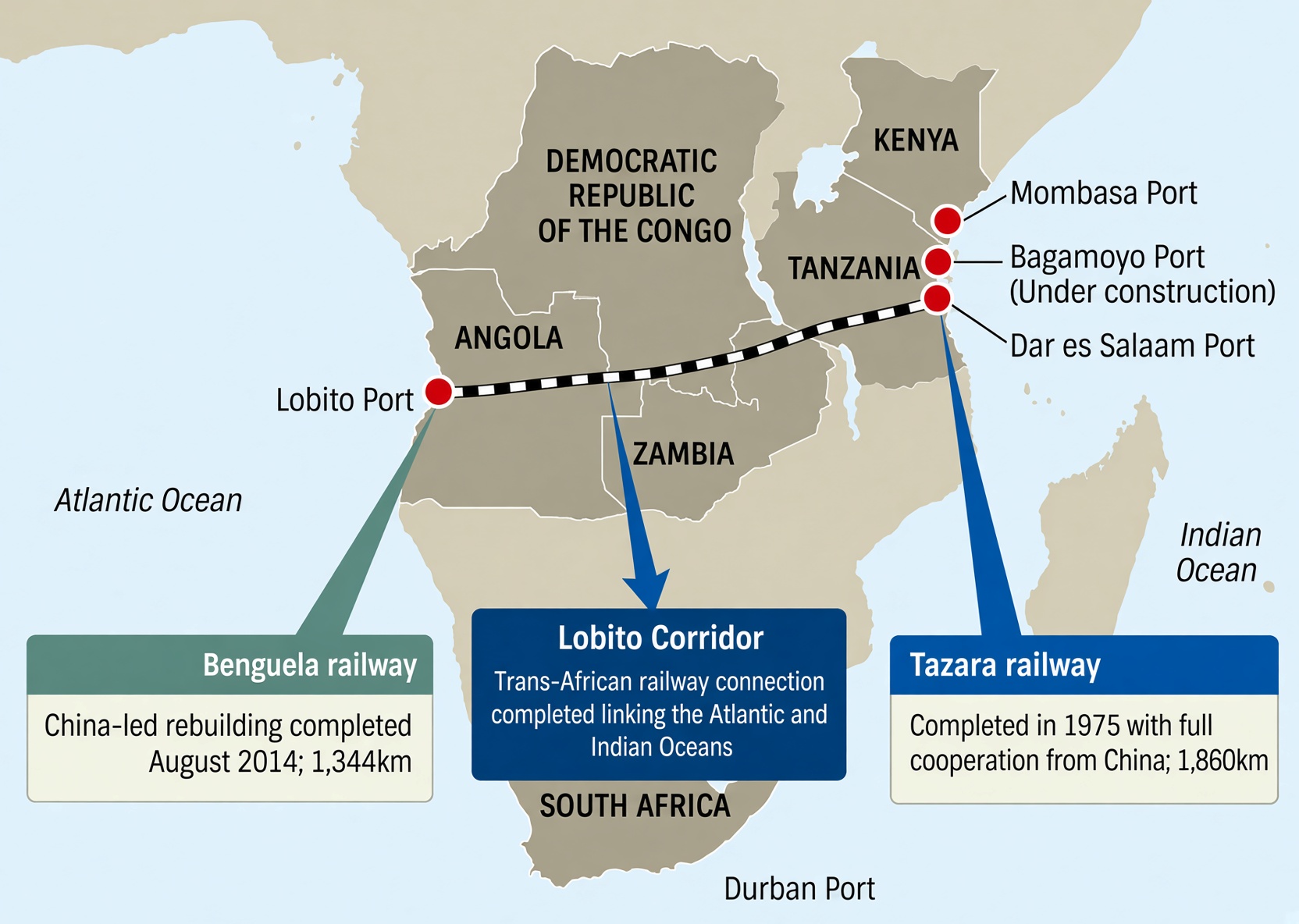

The corridor links the Atlantic port of Lobito to the copper and cobalt regions of the DRC and Zambia. The Angolan section runs about 1,300 kilometres east through Benguela, Huambo, Kuito and Luena to Luau on the border, with a further 400 to 450 kilometres to Kolwezi. Transit takes roughly four days across Angola and between four and eight across the Congolese section. Trafigura describes it as the shortest route from Kolwezi to any African port, at around seven days inland.

Source: CrossBoundary Group, July 2025

The Cargo

Copper and cobalt account for the majority of projected freight, with the corridor also serving lithium, rare earths, germanium, diamonds and general freight. Traffic runs both ways: sulfur imports towards Kolwezi were among the first regular flows, at around 10,000 tonnes a month.

Source: Lobito Corridor guide

The Inheritance

None of this track is new. The Benguela Railway was begun in 1902 and completed in 1931 to connect Katanga to the Atlantic, then destroyed by the civil war, which left only 34 kilometres operational. China Railway 20 Bureau Group rebuilt it between 2006 and 2019 at a cost of around USD 1.83 billion. In 2022 Angola rejected a Chinese bid to manage the line and awarded the concession to a Western-backed consortium instead. Every dollar of American and European money on this page sits on infrastructure China built.

Source: AidData, March 2025

The Concession

Who actually operates the railway

Lobito Atlantic Railway

The thirty-year concession over the railway and the mineral terminal was awarded in November 2022. The consortium is held through Lobito Atlantic Holdings, with the commodity trader Trafigura and the Portuguese construction group Mota-Engil each holding 49.5 per cent, and the Belgian rail operator Vecturis holding 1 per cent. European Commission material describes the same structure in national terms, as a Portuguese 49.5 per cent stake and a Belgian 1 per cent.

Source: Lobito Corridor guide

The Institutional Frame

Development proceeds under a memorandum of understanding signed by the United States, the European Union, Italy, Angola, Zambia, the DRC, the African Development Bank and the Africa Finance Corporation. Angola has established the Lobito Corridor Investment Promotion Authority to market it. The corridor is simultaneously the flagship of the G7 Partnership for Global Infrastructure and Investment and the European Union's largest Global Gateway project in Africa.

Source: European Commission, International Partnerships

The Money

Where every partner in this series converges

The Railway Itself

Financing for the Angolan section reached financial close in July 2026 at USD 753 million, comprising USD 553 million from the US Development Finance Corporation and USD 200 million from the Development Bank of Southern Africa, with Lobito Atlantic Railway as borrower and the Africa Finance Corporation as co-financial adviser. The DFC loan had been signed in December 2025. The Corporation has said the financing could reduce critical mineral transport costs by up to 30 per cent.

Source: Africa Finance Corporation, July 2026

Team Europe

The European Union and its member states are mobilising more than EUR 2 billion, working with the European Investment Bank and nine member states. The Angola-specific components include EUR 50 million for agricultural value chains, EUR 43 million for vocational training with France, Portugal and the African Development Bank, EUR 8 million for the Caála logistics platform with the Netherlands, EUR 100 million of EIB water investment, and EUR 10 million to strengthen civil society organisations along the route.

Source: European Commission, International Partnerships

The Development Banks

The African Development Bank made USD 300 million available for the Angolan side in May 2026 and approved USD 255 million plus a USD 10 million grant for Zambia's participation in August. Its USD 211.4 million agricultural project covers four provinces inside the corridor economic zone, carrying EUR 20 million of Italian Piano Mattei co-financing. The World Bank's March 2026 policy operation names corridor development among its objectives.

Source: Angop, May 2026

The Scale

Taken together the corridor is described as a USD 6 to 10 billion programme across rail, port, road, energy and logistics. Alongside public money sits the USD 1 billion LCID Platform, co-founded in May 2025 by the Menomadin and Mitrelli groups with Angola's sovereign wealth fund, targeting agriculture, infrastructure, healthcare and digital inclusion.

Source: Lobito Corridor, 2026 guide

What Moves Today

The numbers that separate the corridor from the announcements about it

Volumes

The operator moved more than 200,000 tonnes during 2025, its first full operational year, with a record 37,000 tonnes in December and a fleet of around 360 wagons. January 2026 brought a 50,000-tonne sulfur bulk carrier to the mining terminal, the largest handled there. The Port of Lobito handled 931,000 tonnes in the first half of 2026, mostly minerals, with a full-year forecast near 2 million tonnes.

Source: Transportation News and Trends, July 2026

Against the Targets

Rehabilitation targets a design capacity of 4.6 million tonnes a year, with a stated interim goal of 2.4 million tonnes by the third year of operation. Present volumes are therefore a small fraction of the intended throughput. The constraint at the moment is rolling stock rather than the port, which is unusual for a new corridor and means capacity should rise as wagons arrive.

Source: Transportation News and Trends, September 2026

The Anchor Contracts

Commercial viability rests on committed volume. KoBold Metals has signed a memorandum for over 300,000 tonnes of copper a year from its Mingomba mine, First Quantum Minerals and Kobaloni Energy have committed a further 170,000 tonnes, and Ivanhoe Mines has agreed capacity of 120,000 to 240,000 tonnes annually from Kamoa-Kakula. That is roughly 470,000 tonnes of minimum annual freight, which is what lowers the cost of capital.

Source: Lobito Corridor, 2026 guide

Moving Up the Chain

In February 2026 Trafigura, Aurubis and Kamoa Copper announced the first sale of low-carbon copper anode to Europe using the route. The Kamoa-Kakula smelter is expected to produce up to 500,000 tonnes a year of 99.7 per cent pure copper anode after ramp-up, which would make it the largest in Africa. Anode is not refined copper, but it is a step above concentrate, and whether the corridor supports processing rather than raw extraction is the test of its development case.

Source: Lobito Corridor intelligence brief, May 2026

Phase Two

The Zambian extension, which is where the transformative claims live

The Greenfield Line

The larger ambition is roughly 800 kilometres of new railway from Luacano in eastern Angola to Chingola in Zambia, developed by the Africa Finance Corporation, which has committed to mobilise up to USD 500 million for it and a further USD 150 million for the Kamoa-Kakula smelter expansion. The US Trade and Development Agency awarded USD 2 million for the environmental and social impact assessment. The route may pass close to First Quantum's Sentinel and Kansanshi, Barrick's Lumwana, Konkola and KoBold's Mingomba.

Source: Africa Policy Research Institute, March 2026

The Timetable

Construction was scheduled to begin in February 2026, with initial sections targeted for operation between 2028 and 2029, though the extension was still short of financial close in the April 2026 financing timetable. On the existing Angolan line, the contractor restated a three-year rehabilitation schedule in April 2026, pointing to late 2028 for substantial completion.

Source: Transportation News and Trends, July 2026

What It Means for Shippers

The practical division is clear. Congolese copper from Kolwezi and Kamoa-Kakula is already on the railway and is a decision available now. Zambian copper still needs a road leg to reach the railhead, so the Lobito advantage there is partial until Phase Two carries traffic. Greenfield rail of that length on that timeline is ambitious by any standard, and 2028 is the earliest plausible date for a paying tonne.

Source: Transportation News and Trends, July 2026

The Risks

Displacement, derailment, floods and governance

Displacement

A Global Witness investigation published in December 2025 used satellite analysis to estimate that rehabilitation between Kolwezi and the Angolan border could put around 1,200 buildings, some 6,500 people, at risk of eviction. The buffer zone is disputed: the operator says it requires 10 metres either side of the rails for current works, Congolese legislation is cited at 20 metres, and authorities in Kolwezi insist 25 metres will apply. That last five metres would almost double the number of people affected.

Source: Global Witness, December 2025

A local NGO director quoted in the investigation described the project as appearing more political than developmental because affected communities are not being informed. An EU official told Global Witness that resettlement would be examined in detail during feasibility studies expected in 2026 and during implementation, citing the European Investment Bank's environmental and social standards.

Source: Global Witness via allAfrica, December 2025

Safety and Weather

A freight train carrying copper cathodes derailed near the Angolan border on 23 March 2026, reportedly killing at least three people and injuring six. In April 2026, heavy rain in Angola forced temporary suspension of rail traffic after flooding affected bridges over the Halo and Cavaco rivers. Repeated derailments on the Congolese side have been attributed to ageing infrastructure, axle load limits and deferred maintenance. A single line to a single port carries a concentrated risk profile.

Source: Lobito Corridor intelligence brief, May 2026

Governance and Competition

The Extractive Industries Transparency Initiative has warned that governance gaps, weak transparency and unclear rules across mining, transport and infrastructure could undermine investment and reduce how much value stays in the region. A United Nations policy document of October 2024 flagged environmental effects, land and community conflict, and health, gender and human rights risks. Meanwhile China is backing revival of the Tanzania-Zambia railway as an east-facing alternative, so Lobito's volumes are contested rather than assured.

Source: Al Jazeera, May 2026

Editor's Note

Compiled 6 September 2026. This file draws on institutional sources including the Africa Finance Corporation, the European Commission and the African Development Bank, alongside specialist corridor trackers and NGO investigation. Where a claim originates with an operator or a promoter it is attributed as such in the source line. The partners named here each have their own file in this series.

Five caveats. Dates around the railway financing differ because two events are involved: the DFC loan was signed in December 2025 and financial close followed in July 2026. Freight volumes are operator disclosures and have not been independently audited. Capacity figures of 4.6 and 2.4 million tonnes are targets, not achievements, and present volumes are well below both. Displacement estimates are satellite-based analysis by a campaigning organisation, and the operator and EU-linked actors have disputed or qualified parts of that framing. And Phase Two had not reached financial close at the time of writing, so any date given for it should be treated as indicative.

The full story

Section 1: Infrastructure & Route


1.1. Strategic Alignment & Spatial Reach

The Lobito Corridor is a massive 1,739-kilometer transcontinental trade route. In simple terms, "transcontinental" means it stretches across a vast portion of the African continent, connecting the landlocked mining city of Kolwezi in the Democratic Republic of the Congo (DRC) directly to the Port of Lobito on Angola's Atlantic coast. This railway acts as a shortcut to the ocean, helping transport valuable clean-energy minerals like copper and cobalt to global markets much faster than traditional land routes.

To make this long journey possible, the railway is divided into two main sections managed by different organizations:

  • The Angolan Section (1,289 kilometers): This stretch of track is historically known as the Benguela Railway. It is managed by a private group of companies called the Lobito Atlantic Railway (LAR). LAR operates this line under a 30-year concession awarded by the Angolan government in 2022. A concession is essentially a long-term lease; instead of the government running the railway, they have handed over the rights to LAR to manage, repair, and run trains on it for three decades.
  • The Congolese Section (450 kilometers): This section connects the Angolan border to the mining hub of Kolwezi. Because this track is owned by the Congolese government's state railway company (SNCC), LAR does not own or lease it. Instead, they use a track access agreement. This is a cooperative contract that allows LAR to run its own modern locomotives and cargo wagons directly onto the Congolese tracks in exchange for helping to fund and rebuild the line.

One of the most important technical features of this entire 1,739-kilometer railway is that it uses a unified 1,067 mm Cape gauge. In railway terms, a track gauge is the exact distance between the two parallel steel rails.

In the past, different countries in Africa often built their railways with different widths, meaning trains would hit a border and have to stop so that workers could manually unload all the cargo and pack it onto a completely different train. Because the Lobito Corridor uses the exact same Cape gauge width from the mines in the DRC all the way to the coast of Angola, cargo wagons can roll continuously across the border without stopping, saving immense amounts of time and money..


1.2. Engineering Assets of the Railway Network

Stops and Stations as Regional Trade Hubs

Along the Angolan stretch of the railway, there are 67 stations and passenger stops designed to do much more than just let people on and off the train. In rural Angola, these stations act as vital regional trade hubs. For decades, interior towns were isolated from the rest of the country due to poor roads. Today, these train stations serve as bustling open-air marketplaces. Local farmers, craftspeople, and traders gather at the stops to sell agricultural goods, fresh food, and handmade products directly to passengers and transport operators. This active trading turns simple railway stops into economic lifelines, helping small rural villages transition into active, self-sustaining trading towns.

Overcoming Nature: Bridges and the Central Plateau

Building a railway across Angola is an extraordinary challenge because of the country's geography. To reach the copper mines inland, the tracks must climb up the Angolan central plateau—a massive, elevated highland region characterized by rugged mountains, steep cliffs, and deep river valleys. To navigate this difficult terrain safely, engineers had to build or fully restore 42 bridges. These bridges act as giant stepping stones, allowing heavy, mineral-loaded trains to cross deep gorges and wide river basins without losing speed or safety. Without this impressive display of civil engineering, connecting the high-altitude interior mines to the flat coastal ports would be physically impossible.

The $1.83 Billion Reconstruction Heritage

The modern corridor we see today is built on a massive historical effort. Following years of conflict that left nearly the entire railway ruined and unusable, the Angolan government launched a major reconstruction program. Between 2006 and 2014, a state-owned Chinese company called the China Railway 20 Bureau Group (CR20) was hired to completely rebuild the line from scratch under a $1.83 billion contract.

This project was a complete transformation:

  • Workers replaced thousands of kilometers of warped, war-damaged track with modern steel rails.
  • All old equipment was updated with modern signaling systems and cargo warehouses.
  • The upgrade successfully increased the maximum speed of the heavy freight trains from a slow, unsafe crawl of just 30 km/h to a competitive and smooth 90 km/h.

This massive reconstruction laid the structural foundation that allows today's operators to run fast, reliable transcontinental trains across the continent.


1.3. The Port of Lobito: Multi-Terminal Integration

A Natural Deep-Water Advantage

The final destination of the Lobito Corridor is the Port of Lobito, which sits in a unique geographic location inside Lobito Bay. Unlike many ports that are built out on open, rough seas and require expensive artificial barriers, Lobito is naturally protected by a long, 5-kilometer sandspit called the Lobito Peninsula. This natural strip of land acts as a giant shield, blocking strong Atlantic waves and wind, and creating a very calm harbor where ships can dock safely. Additionally, the bay features a naturally deep entrance channel. This is a massive geological benefit because it means large international shipping vessels can sail directly into the port without the risk of hitting the sea floor, and without the country having to spend millions on constant dredging to keep the channel open.

The Dual Concession Framework

To make the port run as efficiently as possible, the Angolan government uses a concession framework, which means they have leased out the operations of different parts of the port to specialized private companies. Today, the port is split into two primary areas managed by two different world-class operators:

  • The Container & Multipurpose Terminal: This terminal is leased to AGL (Africa Global Logistics), which is part of the MSC Group (the world's largest container shipping line). AGL's job is to handle "general cargo"—things like everyday retail goods, machinery, food, and standard shipping containers. Having a global giant like AGL manage this terminal connects Lobito directly to major international commercial shipping lanes.
  • The LAR Mineral Terminal (TMPL): This is a highly specialized terminal operated directly by the Lobito Atlantic Railway (LAR) consortium. Instead of handling standard boxes or mixed cargo, this terminal is custom-built to do one thing exceptionally well: handle bulk minerals like copper and cobalt coming off the trains, as well as imports like sulfur used in the mining process. Having the rail company operate its own port terminal ensures that the trains and the ships are perfectly synchronized, preventing cargo from sitting idle.

Deep-Water Technical Specs

For a port to be considered "world-class," its physical dimensions must be able to accommodate modern giant cargo ships. Lobito's mineral terminal is designed with impressive technical specifications:

  • Port Draft (15.3 meters): In maritime shipping, draft refers to the depth of water a ship needs to float without touching the bottom. A draft of 15.3 meters is exceptionally deep. This allows massive bulk carriers to arrive fully loaded and sail right up to the docks to be unloaded immediately, without having to wait out in the deep ocean for high tide.
  • Quayside Capacity (290 to 310 meters): The quayside is the paved edge of the dock where the ship parks. With a quay length of 290 to 310 meters, the mineral terminal can comfortably berth large, heavy-duty cargo ships.
  • Vessel Capacity (Up to 50,000 DWT): This quayside and deep water allow the port to easily handle ships up to 50,000 DWT (Deadweight Tonnage, which is a measure of how much weight a ship can safely carry). This includes industry-standard large cargo vessels such as Handysize and Handymax bulk carriers, ensuring that African minerals can be exported in massive, cost-effective quantities.

1.4. Capacity, Milestones & Operational Targets

The Long-Term Dream: 4.6 Million Tonnes of Cargo

When a railway is rebuilt, engineers calculate its design capacity—which is the absolute maximum amount of cargo the system can safely carry in a single year when everything is running perfectly. For the fully modernized Lobito Corridor, this long-term target is a massive 4.6 million tonnes of cargo per year. To help visualize this, 4.6 million tonnes is roughly equivalent to filling hundreds of thousands of standard shipping containers with copper, cobalt, and agricultural goods, and moving them across the continent annually. Reaching this design capacity is the ultimate goal of the current modernization program, transforming the corridor into one of the most powerful trade arteries in Africa.

Step-by-Step Growth: The Third-Year Goal

Building up to such massive volumes cannot happen overnight. Like any giant project, the railway uses phased scaling objectives—which are step-by-step targets to slowly ramp up operations over time. The immediate milestone is an interim goal: reaching 2.4 million tonnes of yearly cargo by the third year of operation. Currently, the corridor operates at just a small fraction of this goal because the system is in its early launch phase. However, setting these realistic, stepped targets allows the rail operators to test their tracks, train their crews, and smooth out any operational hiccups before the system is pushed to its absolute limits.

Solving the "Wagon Bottleneck": Bringing in the New Trains

In many newly opened trade routes, the biggest delay happens at the seaport because the docks are too congested to handle incoming cargo. But the Lobito Corridor has a very unusual and encouraging situation: the port is completely ready, meaning the only real limit is a temporary shortage of rolling stock—which is the industry term for locomotives (the engines) and wagons (the cargo carriages).

To overcome this bottleneck, the operating consortium is rapidly expanding its fleet:

  • The railway started with a modest fleet of about 360 wagons in circulation and is actively running 18 powerful GE mainline locomotives.
  • To scale up capacity, the consortium has placed orders for 550 brand-new, modern container carrier wagons. These new wagons are coming from a strategic mix of international suppliers, including Galison in South Africa and CRRC in China.
  • As these hundreds of new wagons and locomotives arrive and are placed on the tracks, the corridor's transport capacity is expected to climb rapidly, allowing the frequency of trains to rise from 12 trains per week to 20 trains per week in the near future.
